Last June a school board’s facilities manager walked me through a building the day after the last bell — corridors rubbed grey at shoulder height, a gymnasium that hadn’t seen a brush in fifteen years, classrooms gone dingy and patched in mismatched colours — and told me I had until Labour Day, no extensions, before four hundred kids walked back in. This post is the case study: how we scoped an entire school, sequenced it into the empty summer weeks, chose finishes that survive a building full of children, and handed it back before the first bell. It’s for Ottawa facilities managers, school boards and institutional property managers planning summer work in a building they can only touch when it’s empty.

1. What a school looks like the day after the last bell
Institutional walls take a kind of abuse you don’t see anywhere else. A school corridor gets backpacks, shoulders, lockers, lunch carts and a thousand hands a day, almost all of it landing at the same height. So the failure isn’t dramatic — nothing peels off the wall and forces a decision. The building just quietly wears down.
In this one, the corridors had a continuous rub-line at shoulder height running their entire length, darker at every door frame and locker surround where contact never stops. The gym was the worst of it: fifteen years of ball marks and scuffs up past ten feet, and a colour nobody could quite name anymore. The classrooms had gone dull and blotchy, touched up over the years with whatever paint was in the storage closet, so the walls read as dirty even where the surface was sound.
None of it was an emergency. All of it was overdue. That’s the trap with institutional finishes — because they degrade slowly and the building is busy, the repaint slides off the capital plan year after year until a decade of “next summer” all comes due at once.
What to look at: walk your building the way a parent does on the first day of school, not the way you do every day. A continuous rub-line down every corridor and worn-through door frames mean the finish is spent — that’s a capital-plan line, not a maintenance touch-up.
2. The scope we locked before the last day of class
On a hard deadline, the planning is the project. With Labour Day fixed and immovable, you cannot discover scope halfway through — there’s no calendar room to absorb a surprise. So the real work started months early, while school was still in session: I walked the whole building and wrote down exactly what was in — corridor walls and ceilings, every classroom, the gym, the washrooms, stairwells and the admin offices — plus the prep each surface needed.
That prep is where institutional jobs are won or lost. A decade of anchor holes, tape residue, corner dents and nail pops has to be filled, sanded and spot-primed first, or the fresh paint just frames every flaw in a brighter colour. Pulling all of that into the written scope is the difference between a number that holds and an “extras” invoice in week six — and on a summer school job, week six is when you have the least room to move.
I handed the facilities manager one fixed scope she could put to any contractor for a comparable number. The time to lock this down is before the building empties; it’s the same reason I tell institutions to book summer painting early rather than scramble in June.
What to look at: before you collect a single quote, make sure every bidder is pricing the same defined scope — every room, every surface, all the prep. On a fixed summer window, a scope you can’t compare becomes a change order you have no schedule left to absorb.

3. Sequencing a whole school into eight empty weeks
The empty building is both the entire advantage and the entire constraint. From the last bell to staff setup week we had roughly eight weeks, and not one day of it could slide. So we split the building into zones and sequenced the slow, single-shot spaces first — the gym, the large multi-surface rooms — while the fast, repetitive work of classrooms and corridors ran in parallel behind them.
We also built the schedule backward from the move-in date, not forward from day one. The job was sequenced to finish with days to spare so the floors could be cleaned, the furniture reset and the building fully aired out before staff came back to set up their rooms. A summer school repaint that finishes on the deadline has actually finished late — the building still needs to be turned over.
The other piece was coordinating around the board’s other summer trades. Flooring and mechanical work were happening in the same weeks, and painting generally wants to follow the dusty and wet trades and lead the furniture reset. Getting that order right up front kept three crews out of each other’s way in a building everyone needed at once.
What to look at: ask any contractor for the actual week-by-week sequence measured against your move-in date, with slack built in before staff return. “We’ll get it done over the summer” with no schedule attached is how a school year opens with a half-painted gym.
4. The finishes that survive a building full of kids

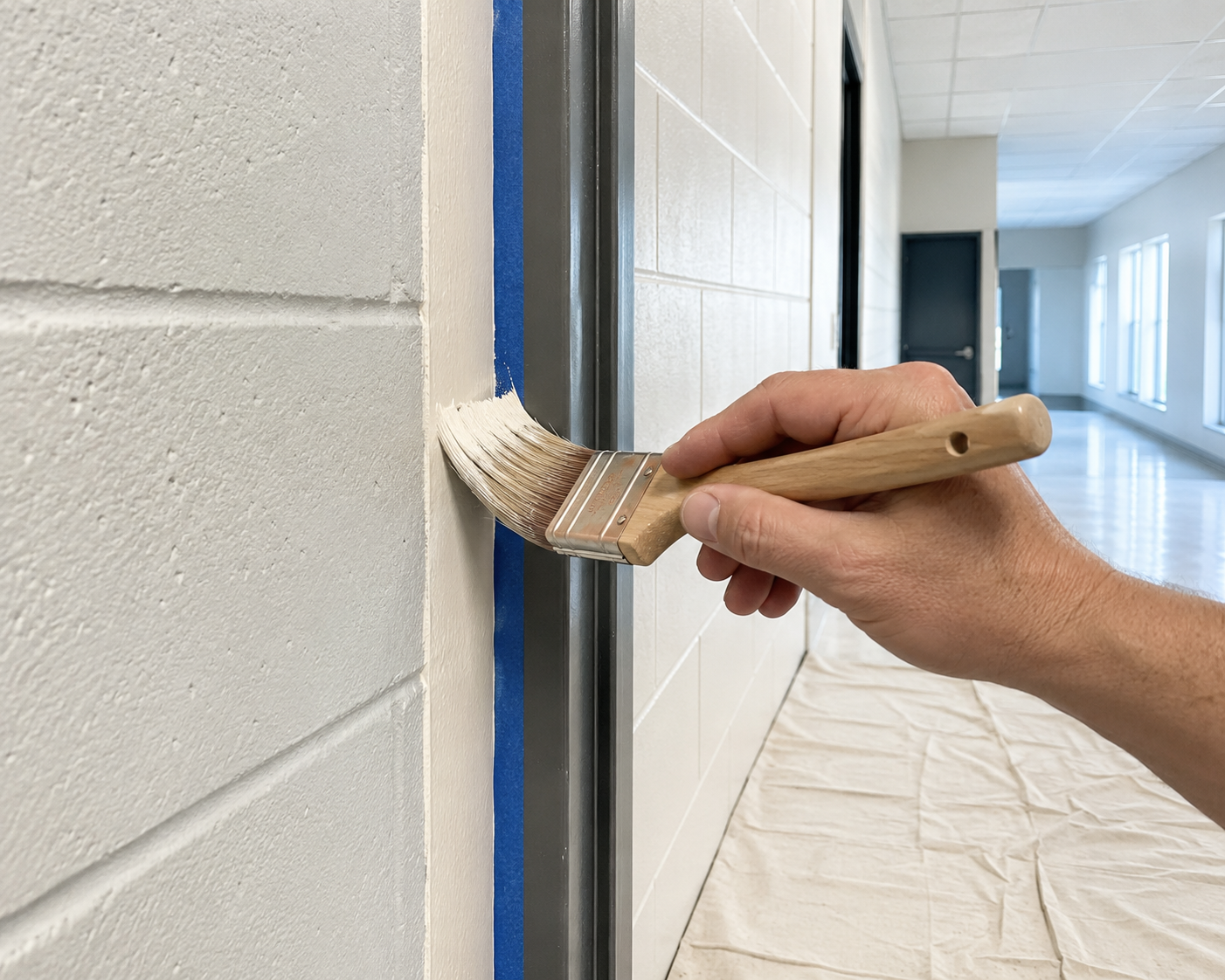

Institutional traffic is harder than almost any condo corridor, so the specification has to match the use, surface by surface. Corridors and classrooms got a scrubbable finish — a washable matte or eggshell you can wipe a scuff or a handprint off without burnishing a shiny spot into the wall. The high-touch trim and door frames got a tougher institutional enamel that stands up to constant contact.
The gym was its own problem. A flat wall paint would be marked up again by October, so it got a harder, impact- and abrasion-resistant coating built for that kind of punishment — the same logic I laid out for commercial protective coatings. Matching the coating to the beating a surface takes is the whole game in a school.
Low odour wasn’t optional. A building children return to has to be genuinely safe and smell-free well before they walk in, so we used low-VOC products throughout — and the long empty window meant everything reached full cure with time to spare, not a rushed airing-out the weekend before. Colour did real work too: warm, bright neutrals to lift the learning spaces, and colour-coded wings so a big building actually reads for a six-year-old finding their class.
What to look at: check the sheen and grade going on each space, not just the colour — corridors and classrooms need a washable finish, high-touch trim needs something tougher, and a gym needs an impact-resistant coating. And confirm every product is low-VOC with real cure time before children return.
5. The outcome — done before the first bell, and on the capital plan
We finished on schedule, before staff setup week, with no overrun into the school year and no half-done space waiting for a weekend that never comes. The corridors read bright and even again, the gym looks genuinely new, and the wayfinding colours do their quiet job the first week of class.
The more useful outcome is what it did for the board’s planning. A properly specified institutional interior finish holds up for roughly seven to ten years — less in the hardest-hit corridors and the gym, longer in the classrooms — so instead of letting the building slide another fifteen years, the repaint now sits on the capital plan with a date beside it and the spaces split by how hard they get hit. The next cycle becomes a planned, modest summer line item walked in over a few weeks, not another all-at-once scramble that only reads as a crisis because nobody looked until it was dire.
What to look at: once a school or institutional building is repainted, put the next cycle on the capital plan with a year attached, and split it by traffic — corridors and the gym sooner, classrooms later. The buildings that never face the panic summer are the ones that treat the finish as the scheduled maintenance it is.
What to do if you’re seeing any of this
If your school, campus or institutional building has corridors rubbed grey, a gym that hasn’t been touched in a decade, or classrooms gone dingy, the work is very doable inside a single summer — but only if the scope, sequence and finishes are planned before the building empties out. I plan and run summer repaints for schools, institutions and multi-residential buildings across Ottawa, including Kanata, Nepean, Barrhaven, Orléans, Stittsville and Manotick, and I’ll map the whole building into a phased plan that lands before your move-in date. We’re booking the July and August window now — you can see how we approach larger projects on our work and services pages, or reach me directly at 613.325.3011 or yasir@heims.ca.
— Yasir, HEIMS Construction
HEIMS Construction is an Ottawa commercial and residential painting contractor serving condominiums, multi-residential buildings, institutions and commercial properties across Ottawa and Eastern Ontario. Members of BOMA Ottawa, the Ottawa Construction Association, CCI Eastern Ontario and ContractorCheck.
